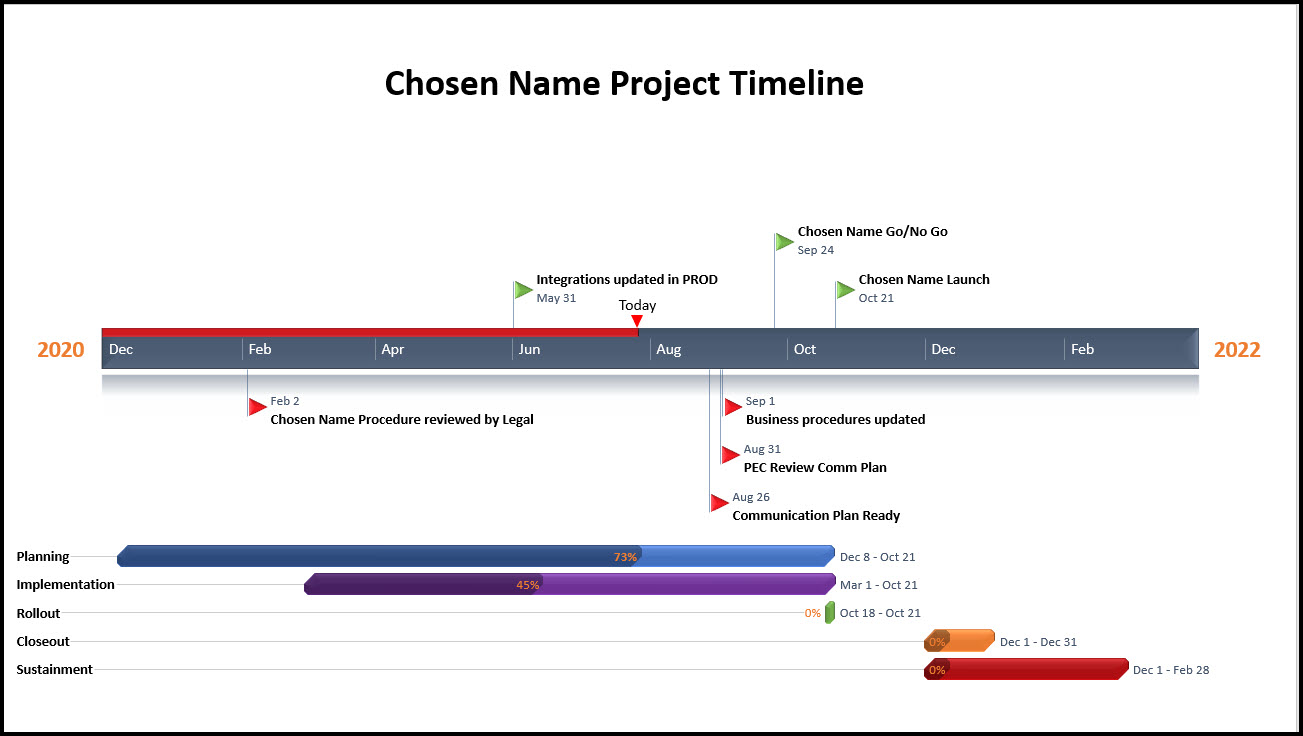

July timeline



  • The colored bars below the timeline represent the phases of the project and provide a percent complete of each phase.
  • The Green markers represent the Chosen name milestone dates when the technology pieces go into Production.
  • The Red markers represent adminstrative milestones for the project.

Chosen name 4-campus target timeline explained:

  1. Planning: December 2020 - October 2021. This phase is on track with 73% of the planning completed to date.
  2. Implementation: March 2021 -October2021. This phase is on track with 45% of the project implemented.
  3. Rollout: October 21, 2021
  4. Closeout: December 1 - December 2021.
  5. Sustainment: Decmber 1 - February 2022.

Milestones

October 21, 2021 – Chosen Name Rollout to BZ, BL, HV, and GF



*Dates are subject to change as this project progresses depending on the needs of the university
